Ground FX: The breakdown

Event 2026 Project Management Marketing Event coordination
Role

Project management and marketing

Timeline

5 months

Skills

Social media, Adobe Creative Suite, project management, event branding.

  • A breaker mid-flare during a battle at Ground FX
  • A breaker frozen mid-air during a battle at Ground FX
  • A breaker performing inside a circle of dancers and judges at Ground FX
  • A dancer striking a freestyle pose in front of the UW Breakers banner at Ground FX

Introduction

During my third term I had the honour and privilege of directing the operations of Waterloo's 30-year-old tradition, Ground FX, the biggest breakdancing competition in the city of Waterloo. On March 29, our team hosted the annual breaking competition organized by UW Breakers, bringing together university students, Toronto dance crews, and the broader hip-hop community for a full day of competitive battles and workshops, in collaboration with 9+ artists and community partners.

As Project Manager and Marketing Lead, I oversaw the strategic planning, outreach, promotion, and execution of the event. Beyond the numbers, Ground FX strengthened cross-city dance connections, elevated the club's presence, and created a space that celebrated hip-hop culture on campus.

Through targeted marketing, we reached over 10,000 viewers, secured ~$4,000 in school funding, and generated additional revenue through merchandise sales.
Jaydon at the Ground FX event, pointed out by an arrow labeled 'Me' among the crowd watching a battle

Main objectives

Being passed the torch for a 30-year tradition is a huge responsibility. To give myself clarity, I broke the event down into four areas of ownership.

Strategic planning & outreach

Secure the venue for both the battle and workshops, and reach out to artists for DJing, MCing, judging, hosting workshops, vending, and dance crews.

Funding & budget

Acquire funding from the school government and endowment funds, budget compensation for each artist, and prepare organized pay on time.

Operations & logistics

Oversee execution of the event: plan the itinerary, and set up the venue, sound system, judging system, and registration system.

Marketing & branding

Build a fun brand aesthetic for the event and create excitement through merch, videos, posters, and websites.

The team

An event is nothing without its key players. The elements of hip-hop outlined what needed to take priority: DJing, MCing, breaking, knowledge, and graffiti. We reached out through email, Instagram, and in-person requests to bring this team together.

The Ground FX MC hosting the event

MCThe master of ceremonies orchestrates the event. This year we invited Switch B, who recently did sports commentary for the 2024 Summer Olympics.

The Ground FX DJ at the decks

DJThe music man of the event, dictating the tunes and beats the dancers battled to.

The panel of judges scoring a battle

JudgesThree veteran dancers who determined the winner of each battle.

A workshop host teaching a breaking technique

Workshop hostsBefore the main event we hosted an advanced breaking workshop and an intro-to-breaking workshop for women and LGBTQIA2+ dancers.

A local dance crew performing an intermission set

Dance crewsLocal crews like UWhiphop and UWstreetdance, along with other university breaking clubs, performed exhibitions between battles.

A vendor table selling streetwear and shoes

VendorsExternal and internal vendors selling shoes, street fashion, and hats alongside the battles.

Process

Five months of runway

Planning started on November 1, five months out. Venue booking, artist outreach, funding and the budget came first, then A/V and the floor plan, then registration and marketing, with the Instagram campaign released in the final weeks.

Gantt chart of the Ground FX timeline from November 1 to March 29: venue booking and artist outreach, A/V booking and layout, registration and marketing material, the Instagram campaign, and a mock test day

Venue and floor plan

The majority of Ground FX takes place in the SLC Lower Atrium, so securing that venue was a top priority alongside confirming our artists. Once the space and talent were locked in, my team and I mapped out the floor plan, registration area, judge seating, sponsor tables, and DJ setup for the best flow and audience visibility.

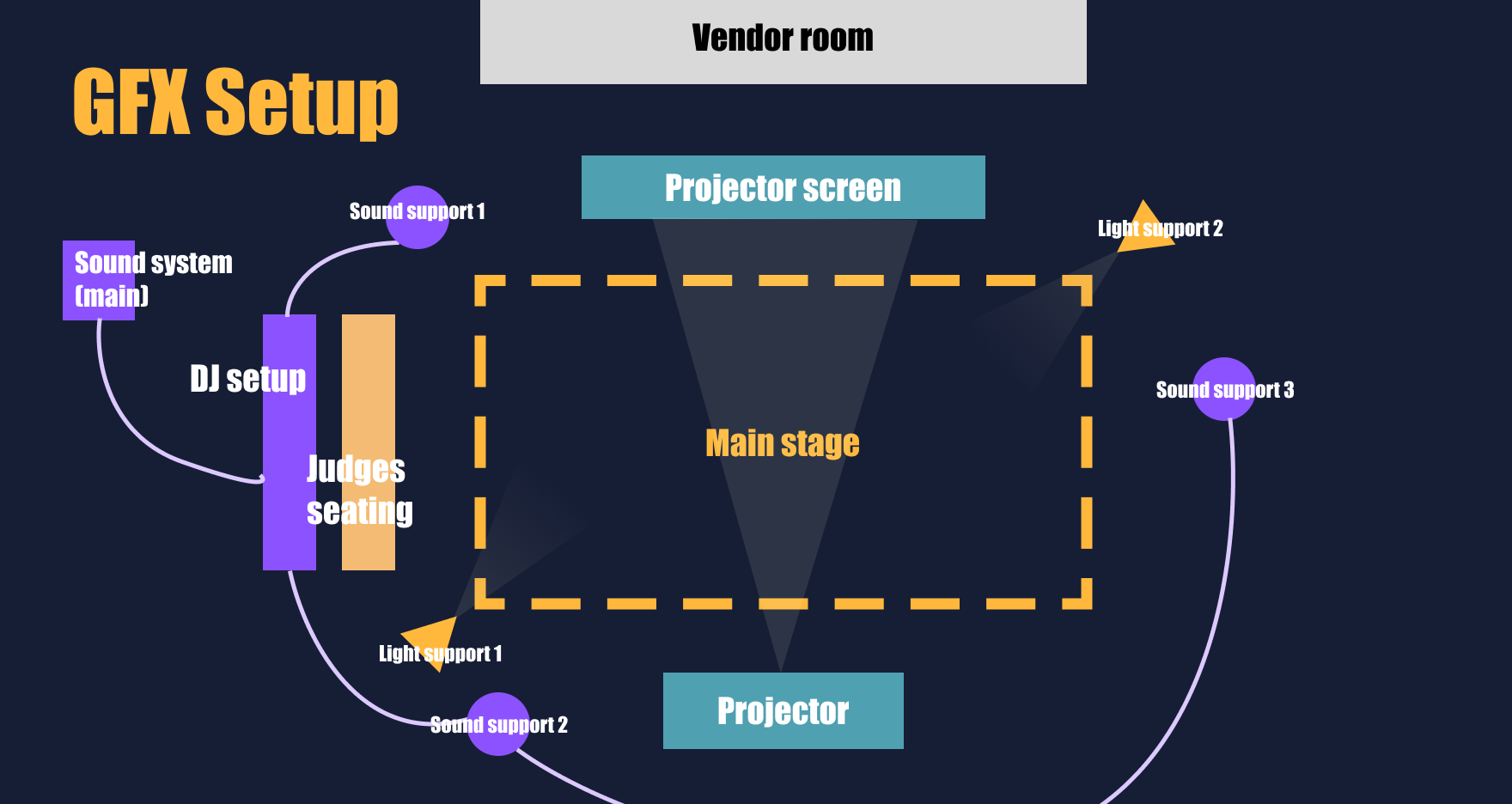

The Ground FX floor plan: main stage with projector and screen, DJ setup and judges' seating to one side, sound and light support around the edges, and the vendor room behind

Budget and funding

With the team, I built and managed a detailed budget covering artist compensation, media coverage, venue reservations, prizes, merchandise, and A/V, then pitched WUSA and Artist Endowment Funds to secure it.

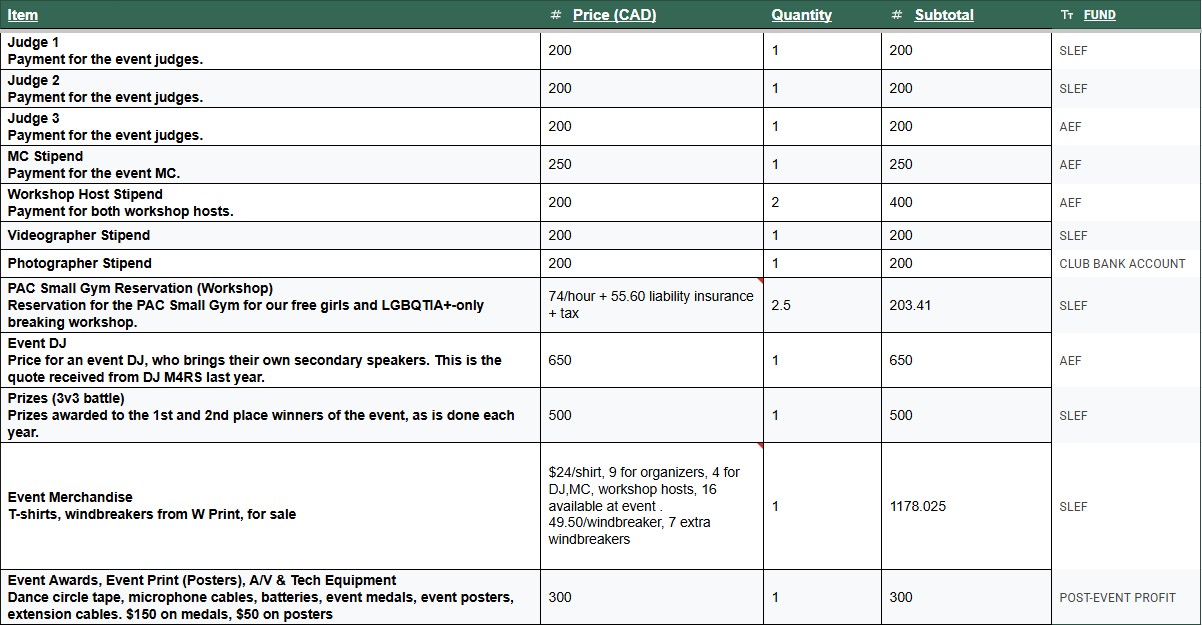

The Ground FX budget spreadsheet, itemising payments for judges, the MC, DJ, workshop hosts, videographer and photographer, the venue, prizes, and merchandise

The test run

To ensure seamless execution, we ran a full test-through the weekend before the event, role-playing it start to finish to catch dead ends before the real day. The day before, we tested the projector and lighting on site.

The day itself

On March 29, doors opened at 1:00 PM for the cypher and registration, followed by the workshops, 3v3 prelims, exhibition battles and UW dance performances, before the top 16 took the floor from 6:00 PM.

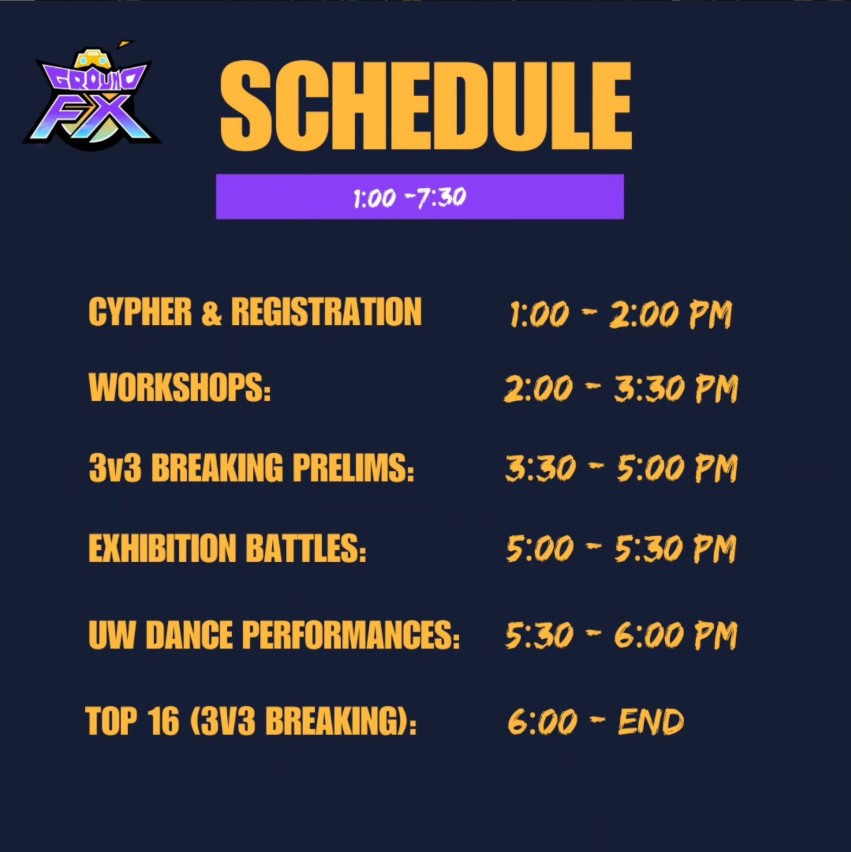

The Ground FX event schedule: cypher and registration at 1:00, workshops at 2:00, 3v3 prelims at 3:30, exhibition battles at 5:00, UW dance performances at 5:30, and the top 16 from 6:00

Branding

From the Instagram visuals to the physical décor throughout the venue, I wanted this year's Ground FX to have a distinct, memorable visual identity. I was deeply inspired by graffiti culture, and wanted that raw, expressive energy to shape the event's look and feel.

I remember sketching logo concepts while watching passing trains, each one layered in graffiti. From there the identity came together, grounded in street art but still cohesive and intentional across every touchpoint.

Ground FX posters for the breaking competition, the judges and the workshops, laid out as a set
The Ground FX logo system: the primary mark with its colour palette, and horizontal lockups on dark, light and purple backgrounds

The logo system: the primary mark, its palette, and lockups for dark, light and purple grounds.

Promotional media

Alongside the branding, I produced the promotional video series for Ground FX's Instagram: a full mixed-media recap shot on a rented gimbal, a teaser, the official announcement post, and a second logo rendition used as a closer.

The recapA dynamic, mixed-media video shot on a rented gimbal, showcasing Waterloo's breaking scene.

The teaserA first taste of what was to come, released ahead of the event.

The announcementThe official post with the full event details.

Logo renditionA second take on the GFX logo, used as a signature closer across the video series.

Creating GFX merch

Along with the dance battles, another tradition Waterloo alumni keep alive is the swag. Every year the club creates new Ground FX-themed merch. Designing and marketing that merch was another piece I got to lead.

Ground FX shirt and windbreaker promo, limited quantities
The back print of the Ground FX shirt, a graffiti-style breaker drawn in yellow and purple

My takeaways

Ground FX was more than an event. It was a full-scale production that required strategic planning, strong branding, and disciplined execution. Leading both project management and marketing let me bridge structure with creativity, and strengthened how I manage stakeholders, budgets, and brand identity all at once.

The earlier the better

Starting the planning five months early was the right call. Every schedule carries the hidden cost of time lost to third-party hiccups, and starting early prevents the last-minute panic.

Bite-sized pieces

This was one of the biggest events I've held, and starting from zero was daunting until the team broke it into smaller milestones, and planning became far more manageable.

Next project
